Does anyone have an example of an 18-24 month EOS implementation plan other than including the dissemination of the various components and practices within the VTO and quarterly rocks? Something that's more like a Gantt Chart or project schedule for implementing the 6 key components and moving toward 100% strong?

Sign Up Now to join the conversation!

Philipp Maucher
Director of Engineering as Marketing / Head EOS (Self-)Implementer

Hi @John Herman159

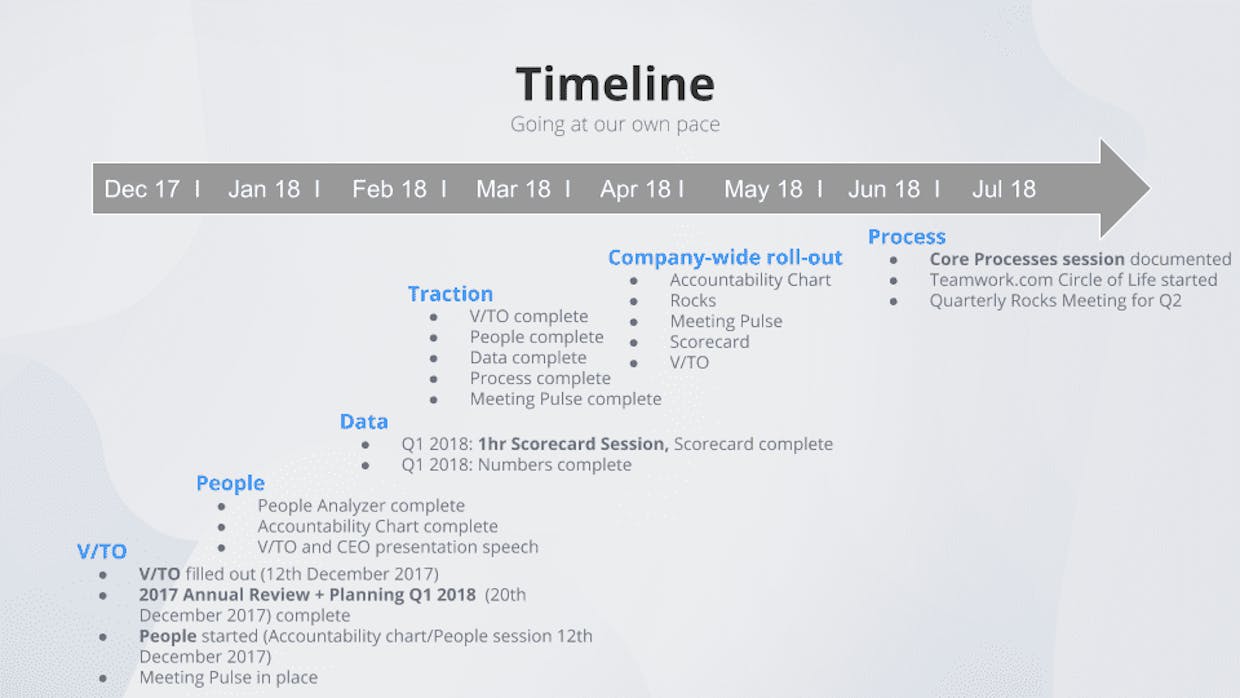

I dug out this slide from 2017 that laid out our implementation plan. In all honesty, it took us a longer than 9-12 months to roll out all 6 key components to all our teams but the sequence worked well for us. Hope that helps!

Does anyone have an example of an 18-24 month EOS implementation plan other than including the dissemination of the various components and practices within the VTO and quarterly rocks? Something that's more like a Gantt Chart or project schedule for implementing the 6 key components and moving toward 100% strong?
Peter Martino
Professional EOS Implementer

Hi John!

Are you familiar with the EOS Process (linked here).232 This is right and proven way to implement EOS. It's not laid out in a Gant chart, but the diagram and the notes below the chart should help clarify the order and timeline. On average a company working with a Professional or Certified Implementer takes about 2-years to "get it" and is ready to graduate if they choose to. Also, if you and your firm are helping other companies Implement EOS, I strongly recommend 2 things: A membership to Basecamp, and going through Bootcamp which also gives you a wide open door to the support and influence of the community. Speaking as an Implementer who tried to do it on my own for about a year, these 3 things have been absolutely priceless in helping me be the best for my clients and frankly myself and my family. If you want to connect offline for a call, feel free to message me anytime.
